A renovation timeline in Singapore needs three dates: when the flat is ready for work, when the approved works must finish, and when you can move in. A quotation’s estimated duration should explain which of those dates it measures.
For HDB flats, check the permit completion deadline before relying on a generic estimate. Planning, off-site preparation and moving arrangements are different from the period allowed for renovation works.
The worked example below schedules eight illustrative weeks for a newly completed BTO flat once it is ready for work. For a resale HDB flat, check the existing-block permit deadline before agreeing dates. The example is not a promised duration for either property.
Use the HDB deadline table, work through the BTO schedule after key collection, or compare how property type changes the programme.
HDB Renovation Deadlines
HDB’s Important Information on Renovations sets these completion limits for renovation works. They are deadlines, not estimates of how long a contractor normally takes.
| HDB block | Completion limit | Clock starts |
|---|---|---|
| Existing block, including a resale flat | Within 1 month | Date the renovation permit is granted |
| Newly completed block | Within 3 months | Date the renovation permit is granted |
| Window-only works | Within 2 weeks | Date the renovation permit is granted |
The permit date matters even if work has not started. Ask the appointed contractor to record the actual permit conditions and completion deadline in your programme. If the proposed scope does not fit, resolve that with the contractor and HDB before relying on the dates. Do not assume extra time is available.
Separate Preparation, Site Work and Move-in

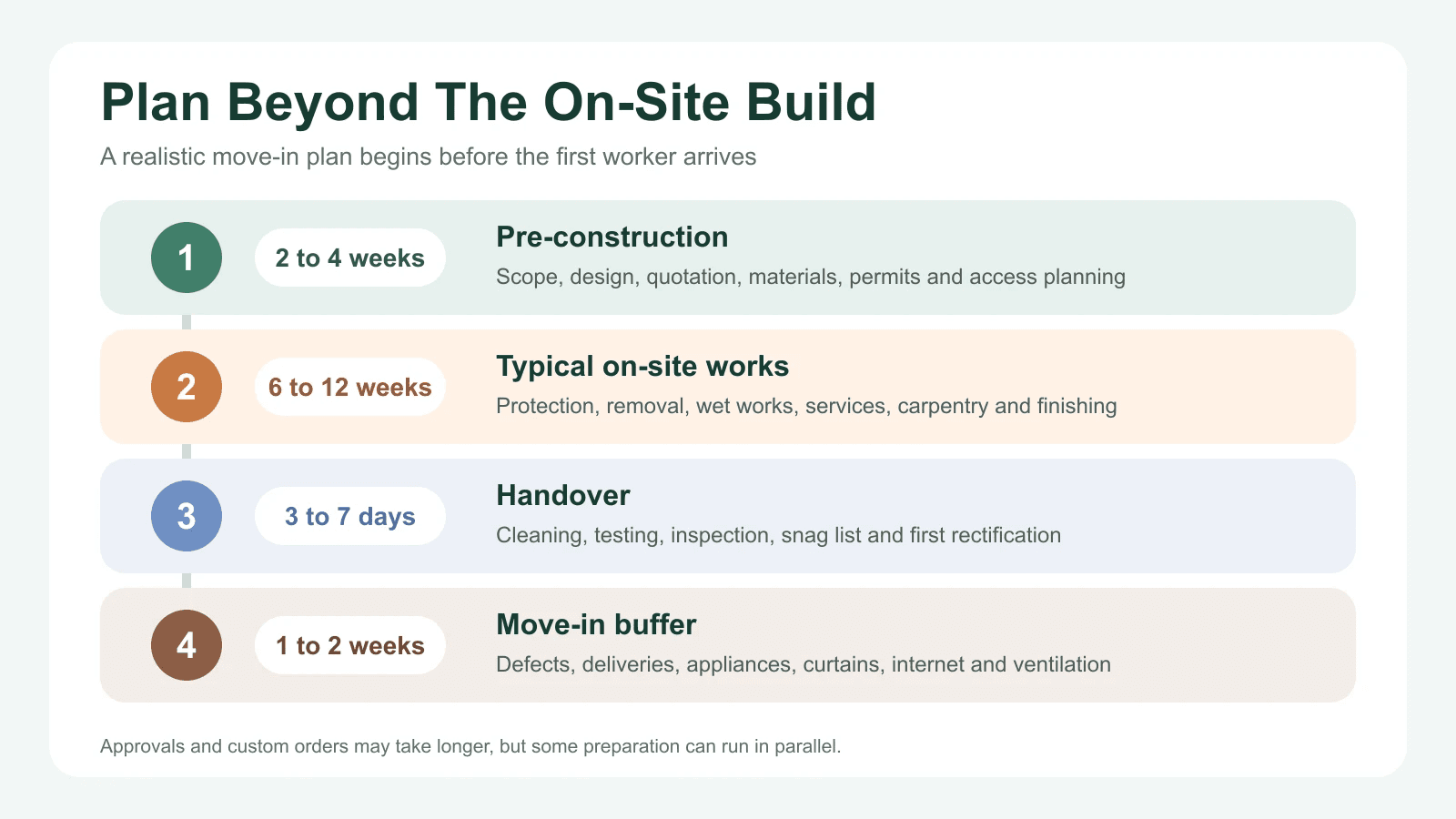

Homeowners often count from the first day workers arrive. A useful schedule starts earlier.
1. Pre-Construction Timeline
This covers the work needed before the site can start:
- Site visit, measurement and scope discussion
- Space planning and design development
- Itemised quotation and contract review
- Material, colour, fitting and appliance selection
- HDB permit, MCST approval or other clearances where required
- Ordering long-lead materials and confirming delivery dates
- Preparing the unit, access arrangements and neighbour notices
Record the time needed for your actual decisions, submissions and supplier lead times. Where preparation overlaps a permit period, account for that overlap rather than treating the permit clock as paused.
2. On-Site Renovation Timeline
This is the visible construction period: dismantling, hacking, wet works, services, carpentry installation, painting, fittings, testing and handover.
Preparation and site work are connected. If the drawings, materials or approvals are not ready, starting demolition early does not make the project faster. It creates idle days and raises the risk of rework.

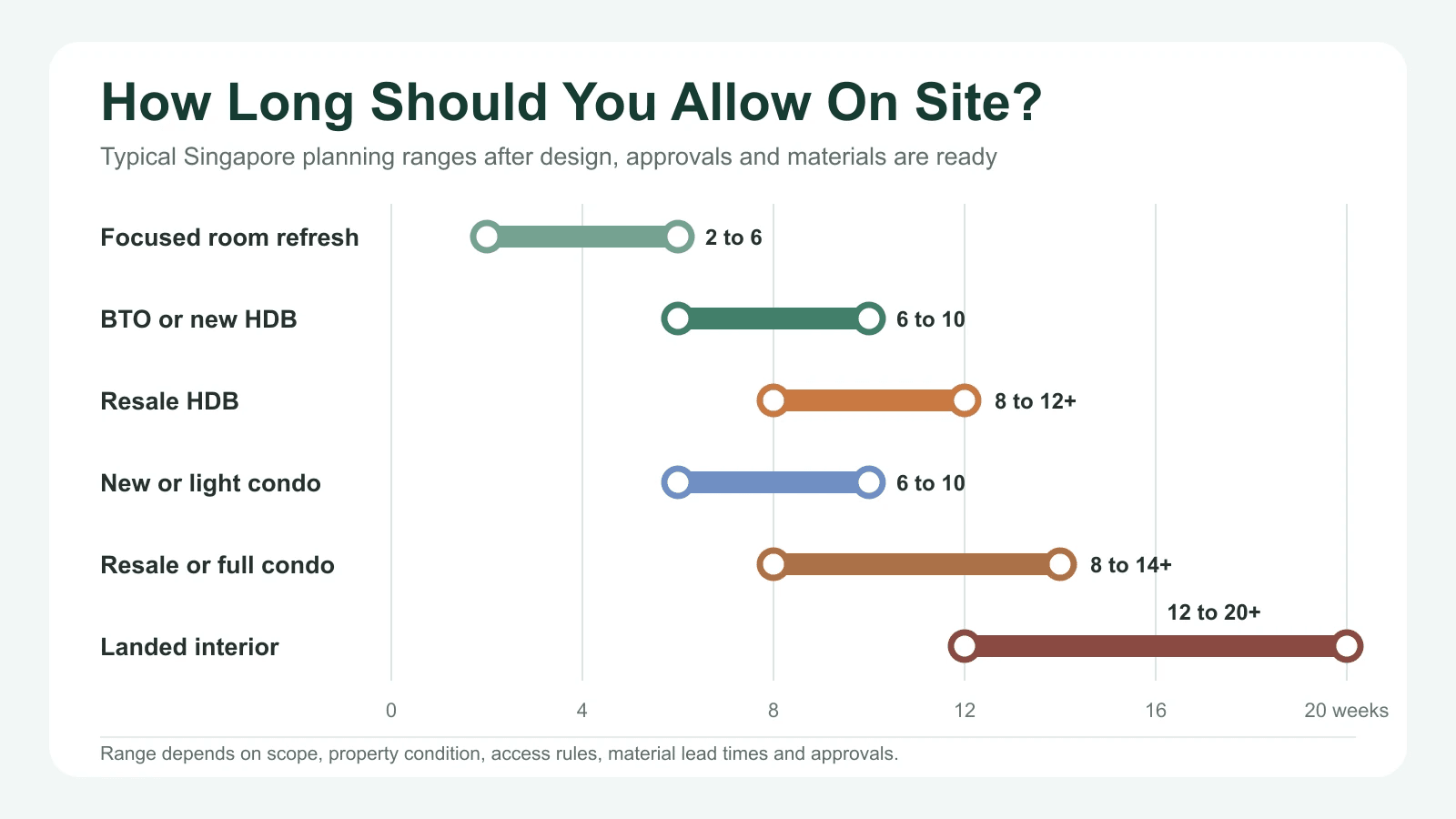

How Property Type Changes the Programme
BTO or New HDB Flat
The selected HDB finishes, measured scope and amount of carpentry determine what is needed. Confirm the handover condition and the agreed sequence for any defect rectification before the affected work starts.
For purchase milestones and handover preparation, use the BTO key collection and defects roadmap. This article picks up at the construction programme once the flat is ready. The BTO renovation packages help you compare scopes before the dates are agreed.
Resale HDB Flat
Removal, repairs and hidden conditions can change the sequence. They do not by themselves create a longer permitted renovation period. Ask the contractor to reconcile the measured scope, trade sequence and materials with the existing-block deadline above.
Ask for separate dates for off-site preparation, site completion and handover. Compare the actual scope through our HDB and condo packages.
Condominium
Obtain the development’s MCST requirements and the contractor’s written programme before booking a start date. Working hours, contractor access, lift bookings, protection and approval documents can affect the usable work window.
A light refresh and a full replacement scope need different programmes. Ask which approvals, materials and access arrangements are confirmed and which dates remain provisional.
Landed Property
Separate interior works from additions, alterations or reconstruction. The larger the scope and the more submissions, specialist works or long-lead items involved, the more important a project-specific programme becomes.
Use the landed house renovation packages to identify the scope, then ask the responsible project team to confirm approvals and sequencing rather than applying a flat-renovation timetable.
BTO Renovation Schedule After Key Collection
The example below assigns eight illustrative work weeks to a newly completed BTO flat. It is a planning exercise, not an average, a Home Reno project record or a completion promise. It does not apply to the shorter existing-block permit period.
Assume a defined interior scope, available selected materials and no unresolved approval or access issue. Before using Week 1, the contractor must confirm the flat is ready, required approvals are in place, and the programme fits the actual permit grant date and completion deadline. Waiting after the permit is granted consumes part of that window.
For inspection and reporting steps before this example starts, follow the BTO handover defects guidance. Keep those records and any agreed rectification sequence clear before new finishes cover the affected areas.
| Illustrative phase | Gate before work moves on | Owner decision |
|---|---|---|
| Before Week 1: release the site | Measured scope, selected items, required approvals, access and defect-rectification sequence are confirmed. | Agree which dates are firm and record the permit completion deadline. Keep mover bookings flexible. |
| Week 1: protection and approved preparation | The contractor checks the approved drawings, site condition and planned work before affected surfaces are changed. | Resolve layout or scope questions before the next trade depends on them. |
| Weeks 2 to 3: services and wet works, where included | The contractor schedules the required trade checks and product-specific curing or testing periods. | Confirm fittings and service-point decisions before work is concealed. |
| Weeks 3 to 5: eligible off-site fabrication in parallel | Approved drawings and any required final measurements are available. Only compatible work overlaps. | Check which supplier dates are confirmed and which still depend on site progress. |
| Weeks 6 to 7: installation and finishing | The preceding surfaces, access and coordinated trade work are ready for the planned installations. | Review outstanding items with the contractor before agreeing the handover appointment. |
| Week 8: inspection, rectification and handover | Required checks and agreed rectification are completed within the applicable works period. | Confirm actual handover and essential-service readiness before fixing movers and major deliveries. |
On a small screen, swipe across the table to read the decision gates. The overlapping rows are not added together. The contractor must replace this illustration with dates that suit the actual scope, site and permit conditions.
If a gate slips, recheck the downstream dates. Do not recover time by shortening required curing or testing, or assume unfinished works can continue after the permitted period. Ask the contractor to address a likely deadline problem with HDB before the deadline is missed.
HDB Rules That Affect Your Schedule
Some HDB renovation work requires a permit, and HDB states that owners should only start those works after the permit is granted. The appointed contractor must be listed in HDB’s Directory of Renovation Contractors.
HDB’s current contractor terms also set clear working limits:
- Noisy work such as wall demolition, tile removal, tile cutting and heavy drilling is allowed from 9am to 5pm, Monday to Friday
- Noisy work is not allowed on Saturdays, Sundays, public holidays or the eves of New Year’s Day, Chinese New Year, Deepavali, Hari Raya Puasa and Christmas Day
- Wall demolition and removal of wall or floor finishes must be completed within three consecutive days
- Other renovation work is generally allowed from 9am to 6pm on weekdays and Saturdays
- Renovation work is not allowed on Sundays and public holidays
These restrictions are why a three-day hacking window does not mean a three-day renovation. The remaining trades still need to follow their own sequence.
For the completion limits and working-hour conditions, use HDB’s Important Information on Renovations, including its General terms and conditions. Check the renovation permit guidance for the proposed scope.
The Most Common Causes Of Renovation Delay
Design Changes After Work Starts
Moving a socket on a drawing takes minutes. Moving it after the wall is finished means opening the wall, rerouting the cable, making good and repainting. The same applies to tiles, plumbing points and built-in dimensions.
Freeze the layout, appliance models, sanitary fittings and main materials before the related trade begins.
Custom Materials And Carpentry
Imported tiles, special laminates, stone slabs, made-to-order fittings and custom carpentry can carry longer lead times. A promised delivery date should be checked before the site programme depends on it.
Approvals And Building Rules
HDB permits, MCST requirements and authority submissions depend on the scope. Submit the actual drawings early. Do not assume an approval time until the responsible party has checked the current requirements.
Hidden Site Conditions
Resale homes can hide corroded pipes, poor waterproofing, uneven walls, old wiring or previous unauthorised work. These problems may only become visible after removal.
This is why a realistic renovation budget and timeline both need contingency.
Poor Trade Sequencing
Carpentry, electrical, plumbing, tiling and painting depend on one another. A late measurement or missing fitting can block the next trade. A detailed schedule should show dependencies, not only dates.
Restricted Access And Working Hours
Condo loading bays, lift bookings, MCST working hours, neighbour rules and HDB noisy-work limits reduce the usable site hours. Include these constraints before confirming handover.
How To Keep Your Renovation On Schedule
- Confirm the scope in writing. List rooms, quantities, dimensions, materials, exclusions and owner-supplied items.
- Lock key decisions before the site starts. Finalise layouts, electrical points, sanitary fittings, tiles, laminates, worktops and appliances.
- Order long-lead items early. Check actual stock and delivery dates, not only showroom availability.
- Submit approvals with complete drawings. Missing information creates avoidable back-and-forth.
- Ask for a phase-based schedule. It should name demolition, wet works, services, carpentry, finishing and handover milestones.
- Hold a short weekly progress review. Compare completed work with the programme and decide any changes quickly.
- Approve variation orders before work continues. Record the added cost and the effect on handover.
- Keep moving arrangements flexible. Confirm completed works, required checks and actual handover before fixing movers or major deliveries.
When Should You Plan To Move In?
Treat practical completion and comfortable move-in as two different dates.
Keep the programme explicit about work completion, inspection and rectification. Once the flat is handed over, coordinate:
- Household cleaning and ventilation
- Furniture, mattress and movable-appliance deliveries
- Internet activation and other services
- Movers and household setup
If temporary accommodation, a tenancy end date or school schedule makes the date critical, discuss a contingency for moving arrangements before signing. Do not book movers for the same day as an unconfirmed handover. A moving buffer does not extend the deadline for renovation works or allow required rectification to be left outside it.
Frequently Asked Questions
How long does a typical HDB renovation take in Singapore?
Use a scope-specific programme and check it against the HDB completion limits above. Preparation before site work and moving arrangements are separate. The worked BTO example illustrates sequencing; it is not a typical-duration claim or a programme for resale flats.
How long does a 4-room HDB renovation take?
Room count alone does not decide the duration. Confirm whether the block is newly completed or existing, then check the scope, approval conditions, trade dependencies and material availability. The contractor should provide dated milestones that fit the permitted works period.
Is BTO renovation faster than resale HDB renovation?
They need different programmes. A resale scope may include more removal and repair, while a BTO scope depends on the selected finishes and built-ins. More work does not itself create a longer permitted period; use the block category and actual permit conditions.
Is the eight-week BTO schedule a promised completion time?
No. It is an illustrative allocation for a newly completed BTO flat after the readiness gates are met. It is not based on completed-project records. Your contractor must supply the actual dates, including approval and completion conditions, before you rely on a handover date.
Can I speed up a renovation without compromising quality?
The safest gains come before construction: settle the design, order materials, complete approvals and coordinate appliances early. Do not save time by cutting waterproofing cure periods, skipping tests or closing walls before electrical and plumbing checks.
How much time should I add for HDB permits?
There is no single allowance for every project because permit requirements depend on the proposed work and supporting documents. Ask your HDB-listed contractor to identify the permits required and submit the completed application before the planned start date.
Why can a condo renovation take longer?
Condo projects must follow the development’s MCST rules in addition to any authority requirements. Access windows, lift bookings, protection, deposits, noisy-work restrictions and approval documents can affect both the start date and daily productivity.
Do I need to be at the renovation site every day?
No, but you should be available for scheduled milestone checks and quick decisions. Useful inspection points include after demolition, before concealed work is closed, after waterproofing or tiling, during carpentry installation and before handover.
Plan The Timeline Before You Book The Move
A reliable renovation schedule starts with a confirmed scope, not a guessed completion date. Share your property type, floor plan, key collection date, must-have work, material preferences and target move-in window. The project team can then identify approvals, lead times and the critical work sequence.
